6.4.11 PH

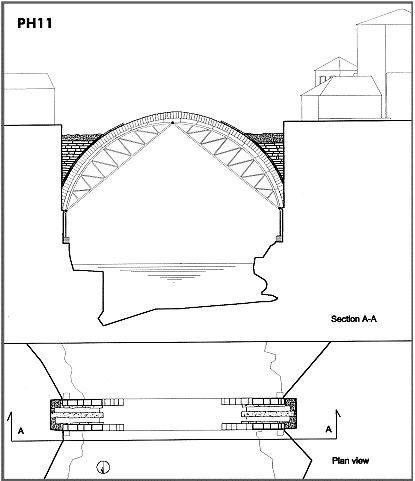

11 - Lower cornices and spandrel assembling
- When stiffening rib construction is on
going, spandrels may be mounted starting, strictly symmetrically, from
both of the arch springers.
- Cornices should be assembled
progressively with spandrels on top.
- Spandrels should be started in time in
order to complete the inner masonry layer facing the lightening void,
without having difficulty of access because of the progression level
of the stiffening rib.
6.4. 12
PH 12 - Load bearing centering release
- Steel centering may be released at this
progression of works so that the bridge arch starts bearing the loads
and settles under compressive stress.
- Settling should be checked and evaluated
by survey of control points.
- Settlings shouldn’t be higher than the
foreseen ones, and arch shape should be verified with design.
- Connections of the stiffening rib to the
abutments should be verified and any eventual crack should be repaired
and reinforced.
- Stone slabs may be placed on top of
lightening voids, strictly symmetrically, from both of the arch sides.
|
